Monday, August 29, 2011

A week has passed and we have been told that within the month (by the end of September) the house should be complete and will be handed over to us.

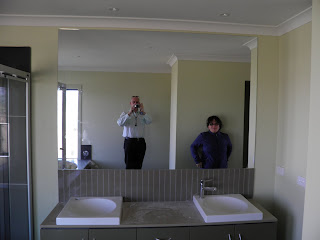

The mirrors have been installed in all the bathrooms as have the shower cubical's, the bathrooms are complete.

In the mud room the ethernet cables from each bed room the study and TV points all come back to this point. Now I need a patch panel, and a 16 way switch, that way everything we have digitally (music photos, video's etc) can be seen from any TV and computer in the house. As well as each computer having a wired connection.


The staircase as it should be not painted green, just wood the way we intended it to be.
The space under the stairs will be utilised as extra storage space (suitcases, vacuum cleaner etc). We will need to get a carpenter to put the door in for us when they have replaced the plaster work.


Waiting for the stain on the stairs (Nordic Teak)

Some vague running repairs on the plasterwork and walls and retouching the paintwork.


I know it looks kinda strange, a photo of the toilet, but notice the seat is neither up nor down. Both the seat and the lid are soft closing so there will be no banging of the toilet seat/lid during the night !


One more of the outside with the back garden just to show the sun shining in Melbourne.


Now we (me) have to start thinking of drainage pipes in the back garden as the soil is quite heavy clay, without digging pipes into the soil to help drain garden it will just be a boggy mess. As its too late this year to plant the garden up I will spend a lot of the time digging a lot of organic material, gypsum, bone&blood into the soil to get it ready for the 2012 season.

Saturday, August 20, 2011

A beautiful sunny day in Melbourne, Spring has finally sprung, another trip to the house
to see what progress has been made since last week..
The ground is nice and dry, we will need to think what driveway we want/need to install.
Every time we arrive more 'crap' is added to the ground to allow the trucks/vans onto the site
for deliveries and work men.



Most of the ground floor is now tiled, they have left, the study, downstairs toilet and near
the staircase still need to be done. This (we guess) will be done when the staircase is replaced.
The grout that has been chosen by the tilers looks fine. Its hard to see on this photo but the electrical work is now complete, lights, sockets and air conditioning vents (alongside TV, Internet & Phone points).



Here is the kitchen with the splash-back in-place, still waiting for the oven, extractor hood & hob still missing. You can see on the right of the picture where the tiles are missing.



The beautiful tap we have on the island bench, with the under-mounted double sink.



The pantry, just off the kitchen, the shelves have now been put in. Just waiting for the hob and range hood to be installed (they still need to cut a hole in the wall, for the hood to vent into the garage). Will send another e-mail to the people from Porter Davis and ask when they will do this, they have been promising to do this for a couple of months now.



One of the walk in robes in the master bedroom (there are two in the master, his and hers).
plenty of space for all my clothes (in fact I'll need to buy a whole heap more if I am to try and fill it.



The shower in one of the en-suits tiling complete, just awaiting the shower screens.
But after that whats left to do ?



Toilet installed, just the bidet and the bathrooms done.



And finally a view from the top of the stairs



All the lights appear to be working, we tried to switch them all on and off.

We need confirmation as to the completion date:
One thing we find strange, is the painting was done before a lot of the 'dirty' work
was undertaken.
The walls now have a lot of marks on them, something else to chase them up about.

Sunday, August 14, 2011

1 week on and look at the difference. Turned up at the house Saturday morning (did not think there would be any tradies on site only to find 3 young guys there laying tiles.
Giorgia scared the life out of one of them by telling them they where the wrong colour tiles !
She had her sun glasses on, so the tiles looked too dark, once she removed her glasses everything was fine.

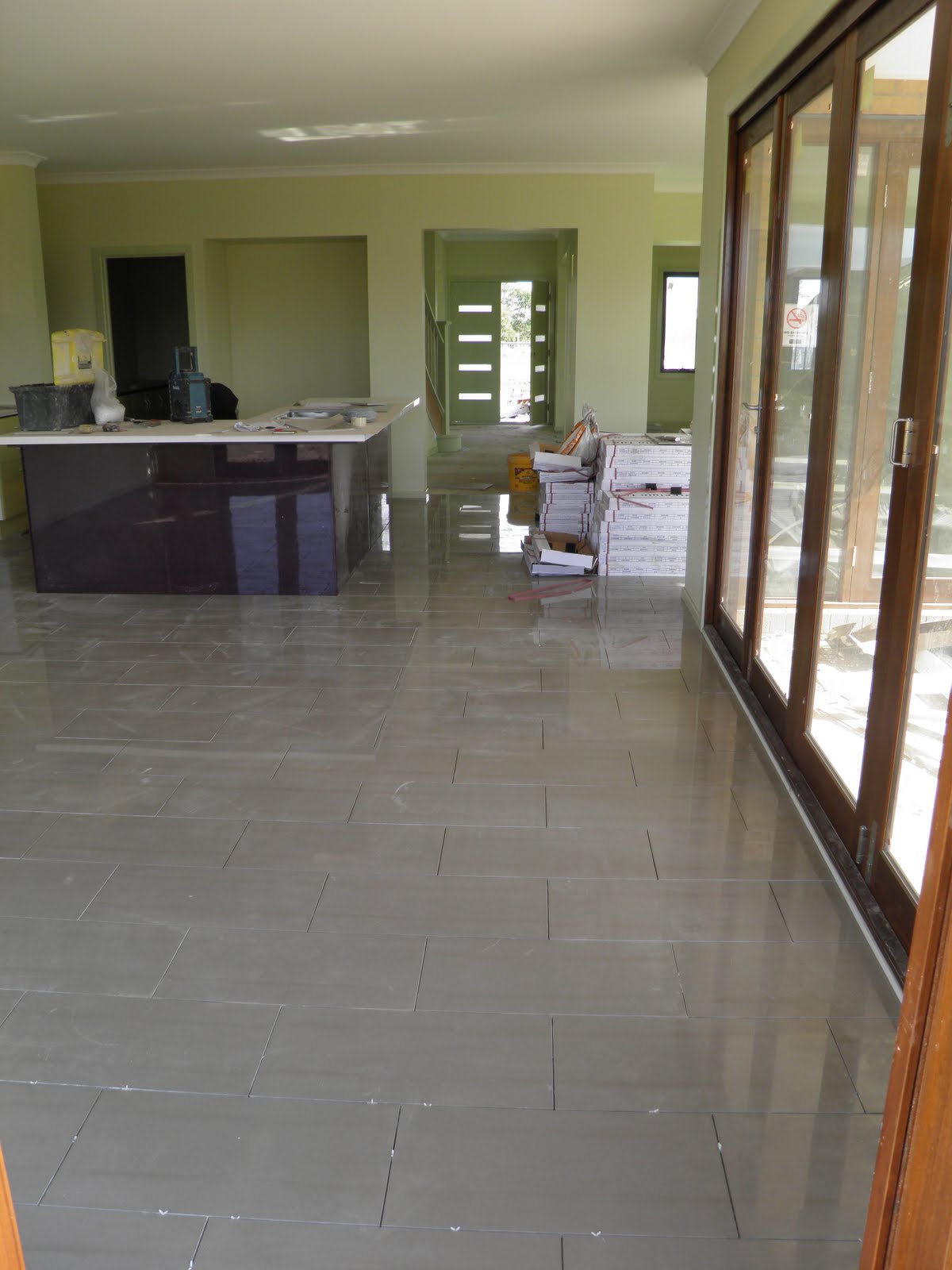

So here is the view through the lounge, the tiling has been done almost to the front wall and to the stairs on the right of the picture. We are happy with the colour across the house floor downstairs.



Here is the view through the house from the back door, the colour we selected for the kitchen does actually go with the tiles (choosing all the colours at different times and places over a year ago, you kind'a forget what you picked).
The tradies where still on site on Sunday as we had to go back and pick the grout (the grout we had originally chosen would 'dry-patchy' and would look bad). At least the tilers phoned to tell us (and not just do the job with something that would look bad) and finding a replacement grout so quickly.



The tiles for the bathroom.... I know black ! We wanted something that would contrast with the rest of the house colours, so black it was. We think it looks good. What we are surprised about is the fact they did not get to the ceiling (its only another 10cm) and also next to the window, a small piece of tile and then nothing!! We have spare tiles so perhaps when the building is finished we can get that done.



And here is an example of the en-suits in the other bedrooms.
What we are thinking about know is ... What is left to do. Shower screens, toilets and
all the electrical points and lights... Why will this work take another 6 weeks to finish ?


Another e-mail to Porter Davis now to let them know about the

i) Broken window
ii) Not double glazed windows in the corners
iii) Window frames not sealed against the outside world (gaps at all the corners)
iv) Missing window in the master bathroom
v) Garage not weather tight

Anything else ? Not that I can remember at the moment, but I am sure there is.

Sunday, August 7, 2011

Its been a couple of weeks since we last posted anything, as we have been waiting to hear what Porter Davis would do regarding the painted staircase (people where on holiday, and waiting to hear from their bosses etc ....). To cut to the chase, they will replace the whole staircase (we will inform them not to paint or stain any part of the staircase.
We turned up at the house expecting to see the tiling complete (as we had spoken with the site supervisor on Monday, who was with the tiler at the time). No tiling has been done :-? Is this because the staircase will be replaced or the wrong tiles have been delivered, only time will tell.

Onto the 'problems' they all fall into the same problem : sealing against the weather!




The seals between the brickwork have not been fitted in here (on the step at the front door here).



The same thing with the garage join to the house and over the garage door. Its hard to see on this photo, but the next you can see light through the wall.



Here we are inside the garage: There should be a seal in between the brickwork here.
Its a little strange that they have not sealed the garage against the weather when they have plastered the roof area (including cornicing)! All it will need is heavy driven rain and they will be replacing the plaster roof.......
We have to assume the builders know what they are doing and that there wont be any rain blown in.



The next two photos show another 'rain related' problem. There are two down pipes to take the rain from the roof and then into the storm water drainage system. Unfortunately there is no drain anywhere near the downpipes, so we can only guess that more digging will be needed to put the drainage system in. Also on the back of the house I am not sure there is a downpipe on the house plans, time to check the plans once again.



The fact that these two downpipes do not lead into a drain is concerning: we had to pay extra for a specific slab 'upgrade' one of the details of the slab is the ground has to slope away from the foundations as water straight onto the slab will be a problem (will have to check the details and "ask" if the water pouring onto/under the slab will be a problem (if its not, is it because its not the slab we paid for)....



The bench top has now been installed in the kitchen, pantry, and bathrooms.
The paintwork has now been finished (there are a few places where they will
need to get scaffold into reach the areas) and obviously when they take the
stairs out they will need to paint around that area again.


The pantry sink has now been installed. we are still wondering when they will start to get some of the electrical work done ! It seems to be the hard way to do this, everything nicely painted now they have to cut holes through the plasterwork (ceilings and walls) to find the electrical cables?



Laundry : As stated above, the plaster work and painting has been finished
and now they have had to cut quite big holes in the plaster to find the pipes
(slightly larger objects to find than a speaker wire), we will be checking on
the holes they cut out to fit the electrical components.


Tiles have arrived (are they the correct tiles)? are they still packed
as the tiler does not want to start until the staircase is finished ?
Next week we will have to see, the staircase will take approx. 3 weeks
to deliver ....... Delays ?


To confirm they will have trouble locating pipes and electrical work, look at the size of the hole they have cut through the shower wall to get to the pipe work, lets hope they do some repair work on this hole, paint the repair with the 'blu sealant' before the tiling.


The last problem one of the floor boards upstairs needs to be replaced as it is broken you can feel it move/bend when you stand on it.
